Rajput Rohan Singh

CT3596

UCT20116

This directed research project investigates and compares the standard bidding documents and percentage rate contract models employed in construction projects across India and international frameworks. Specifically, the study examines three key contractual systems: the CPWD Conditions of Contract (India), FIDIC Green Book (International), and NEC Engineering and Construction Short Contract (NEC3 ECSC). By conducting a literature review, clause-level analysis, and expert surveys, the research identifies key similarities, differences, strengths, and limitations of each model. Through a mix of qualitative data analysis and case studies sourced from CPWD, R&B Department, and Western Railways, the project evaluates the applicability of these contracts in the Indian context, particularly for small-scale projects. The findings provide practical recommendations for adopting best practices and enhancing contract effectiveness to ensure more efficient, transparent, and dispute-minimized project delivery.

View Additional Work

Report Content

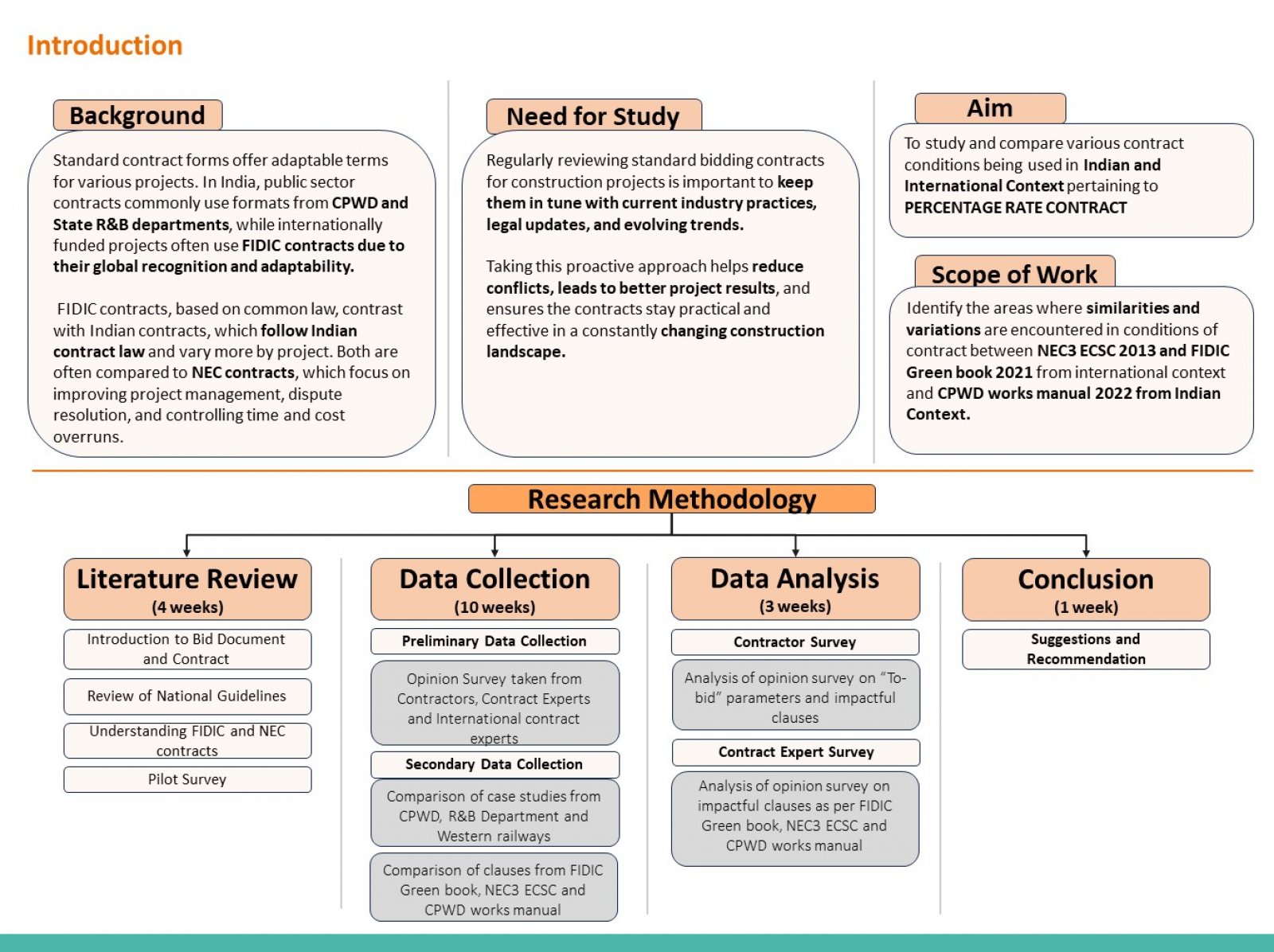

Introduction for DRP

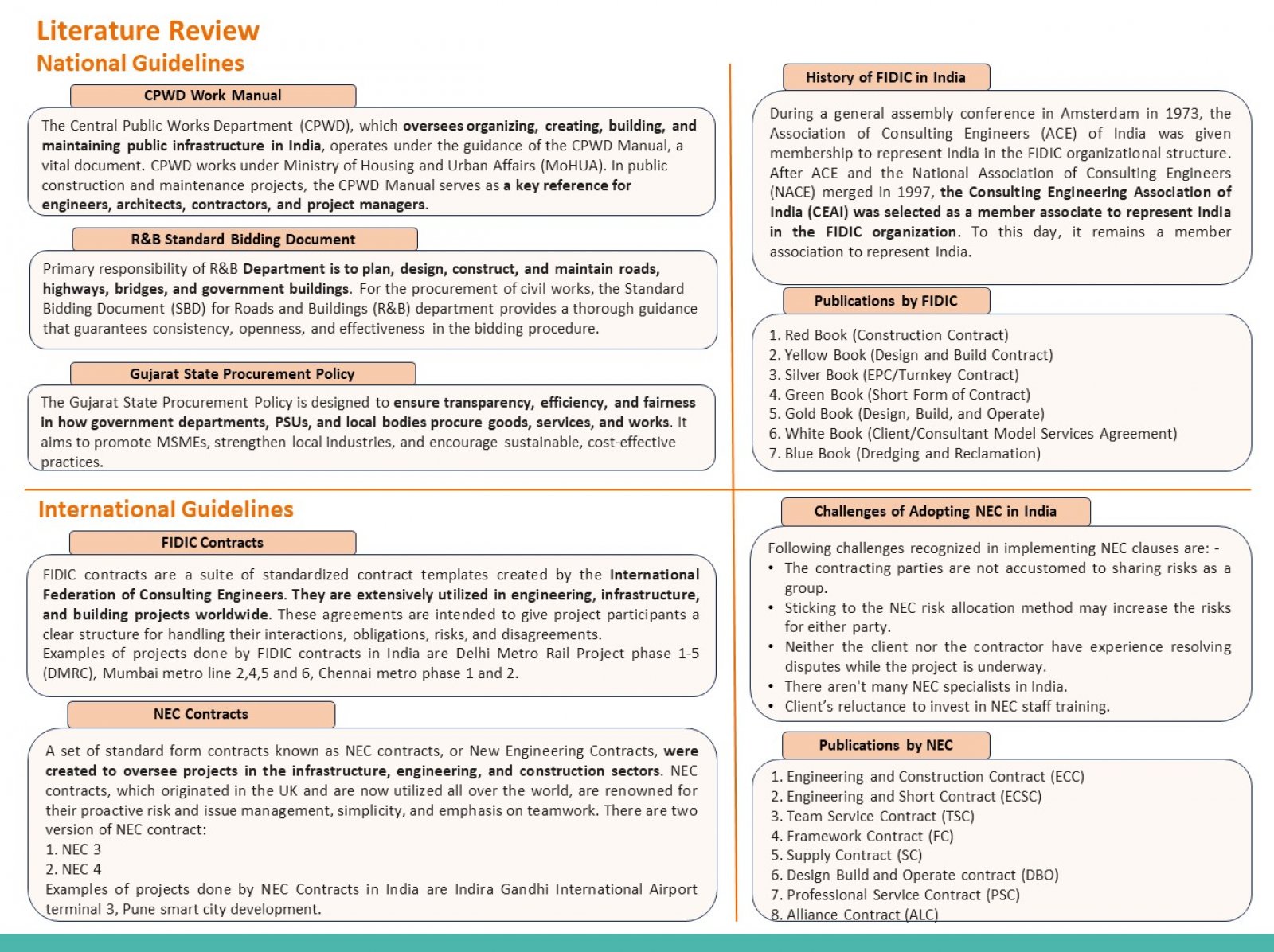

Literature review of National and International Guidelines

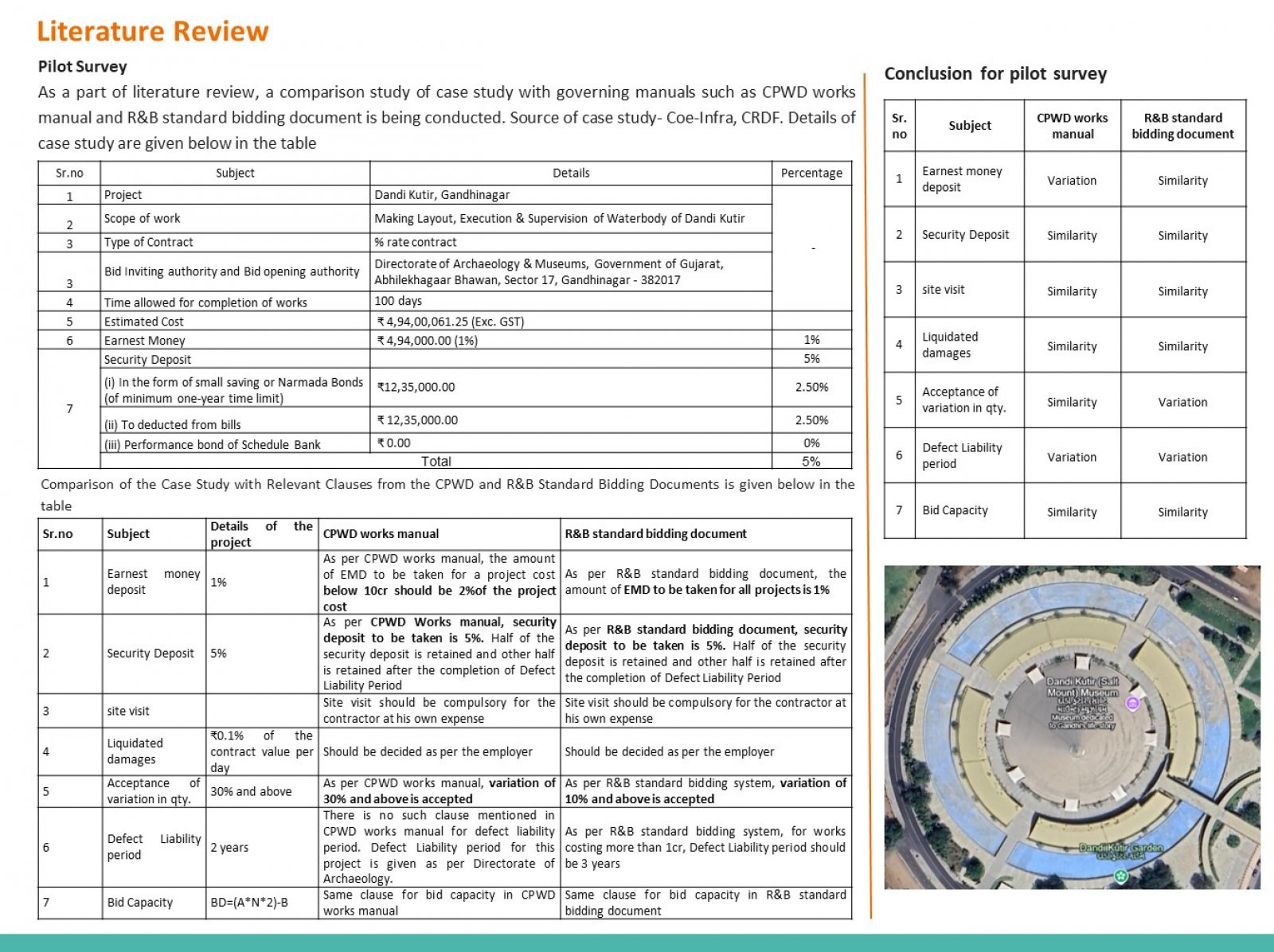

Pilot survey for literature review

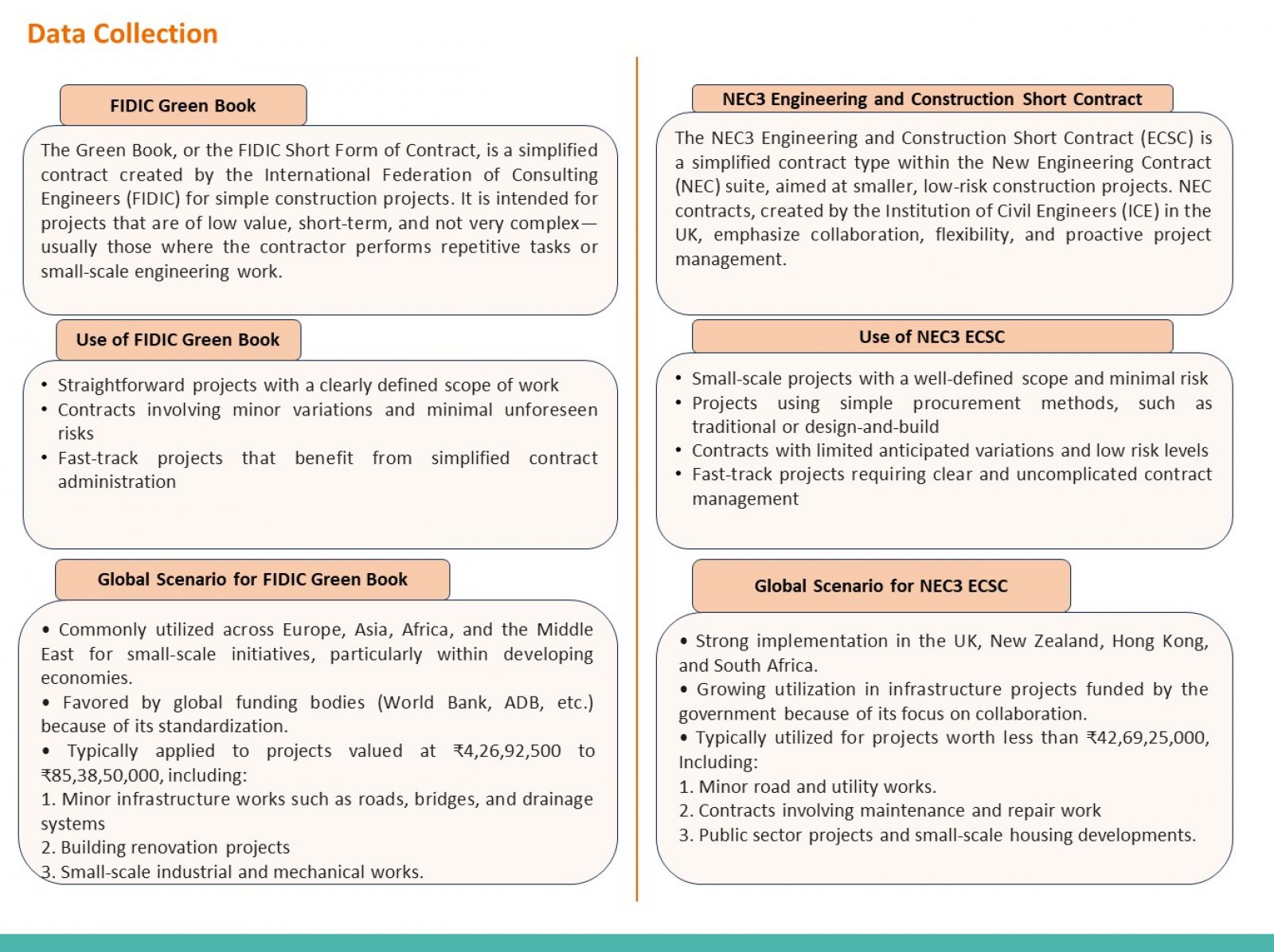

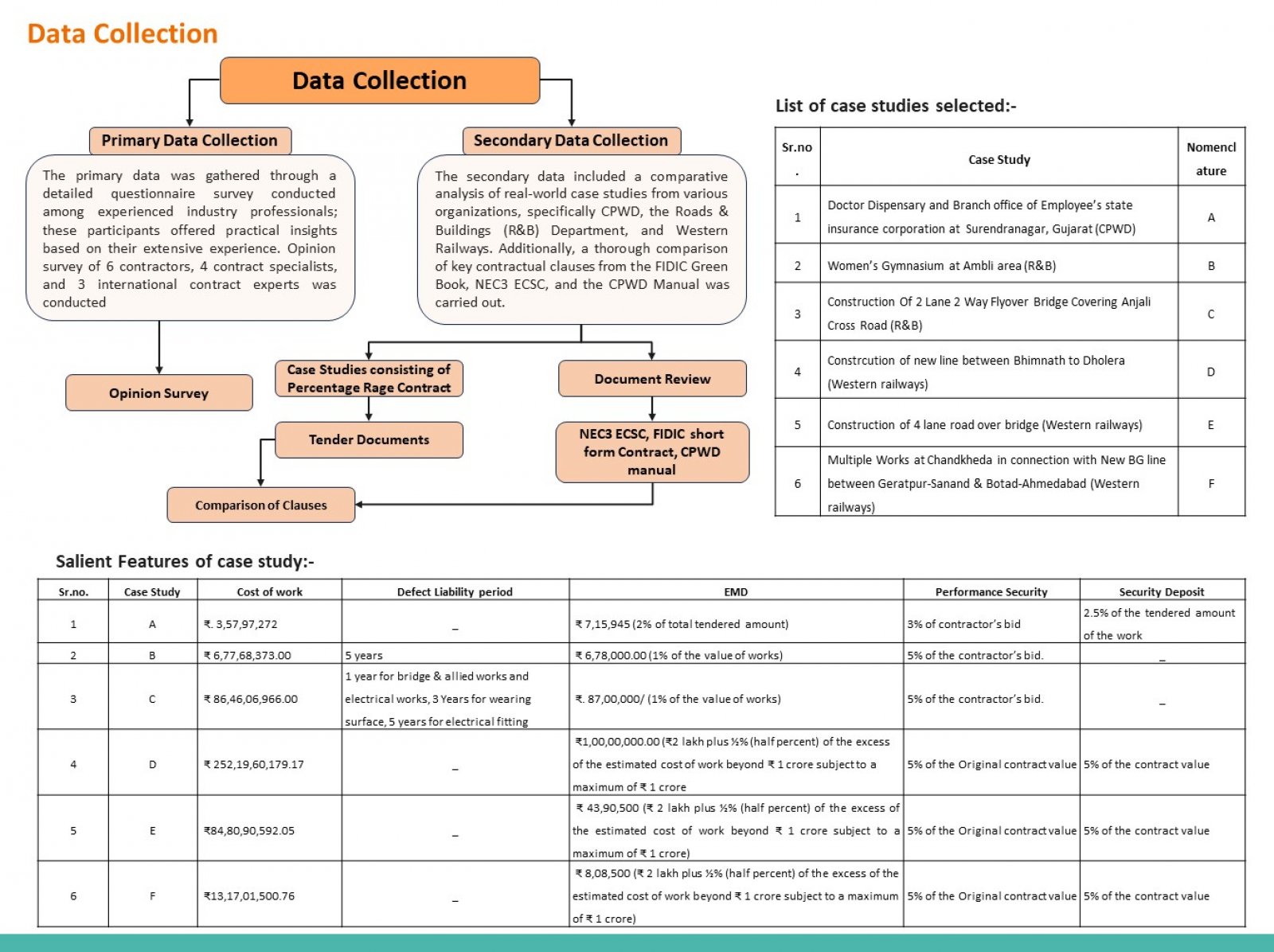

Introduction to data collection

Introduction to FIDIC Green book and NEC3 ECSC

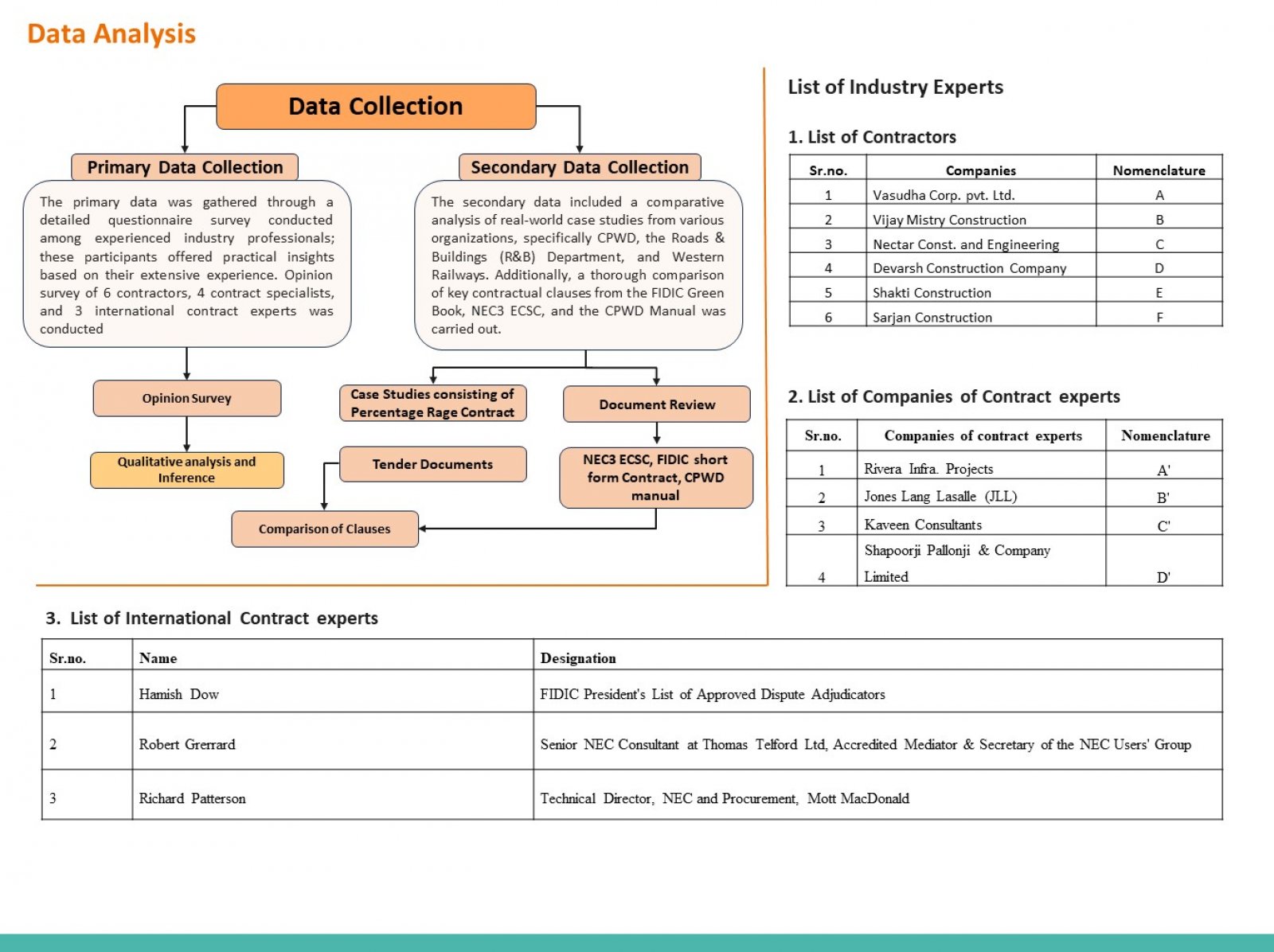

Introduction to data analysis

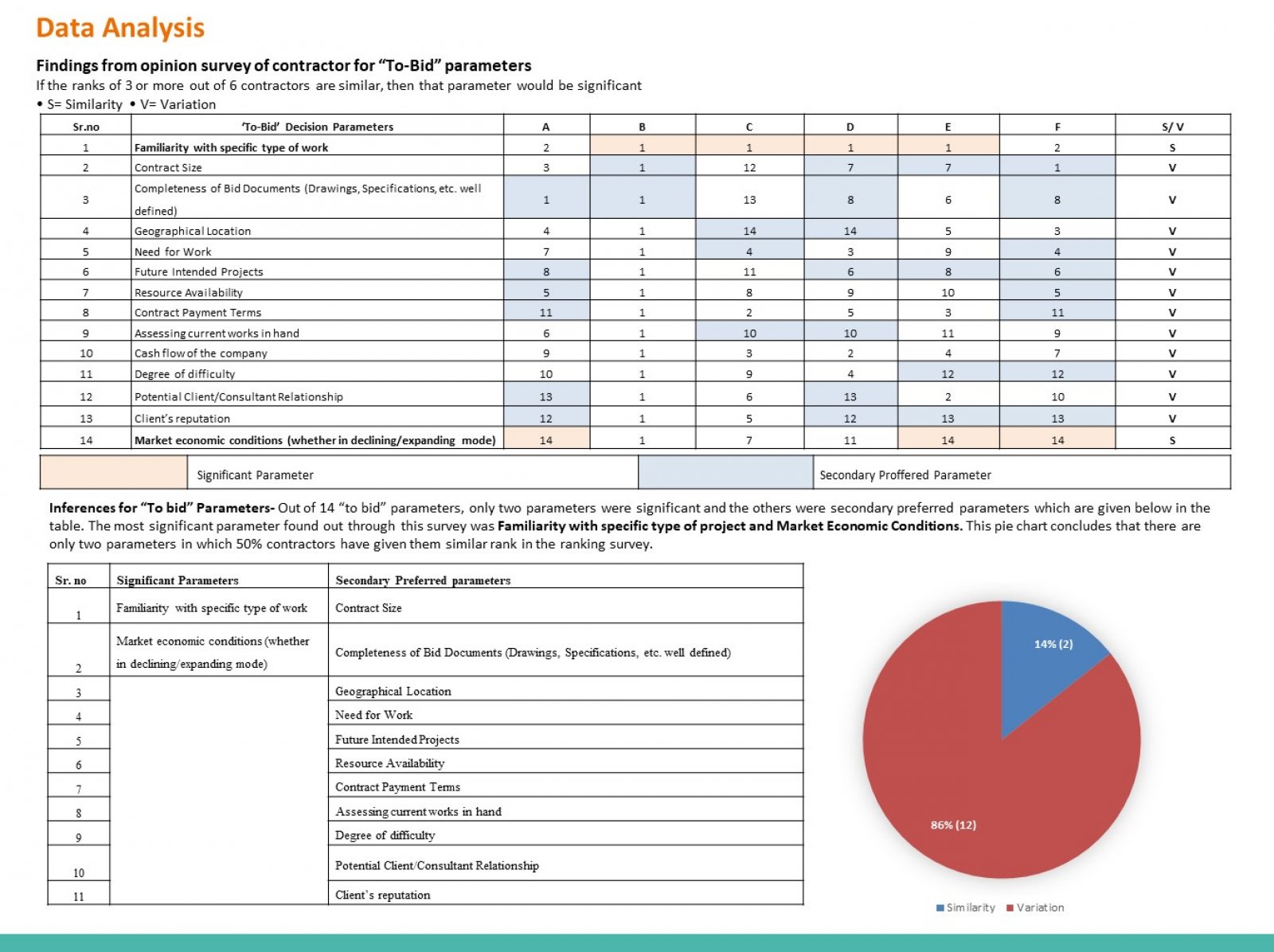

Findings from the opinion survey of contractor for “To-Bid” parameters

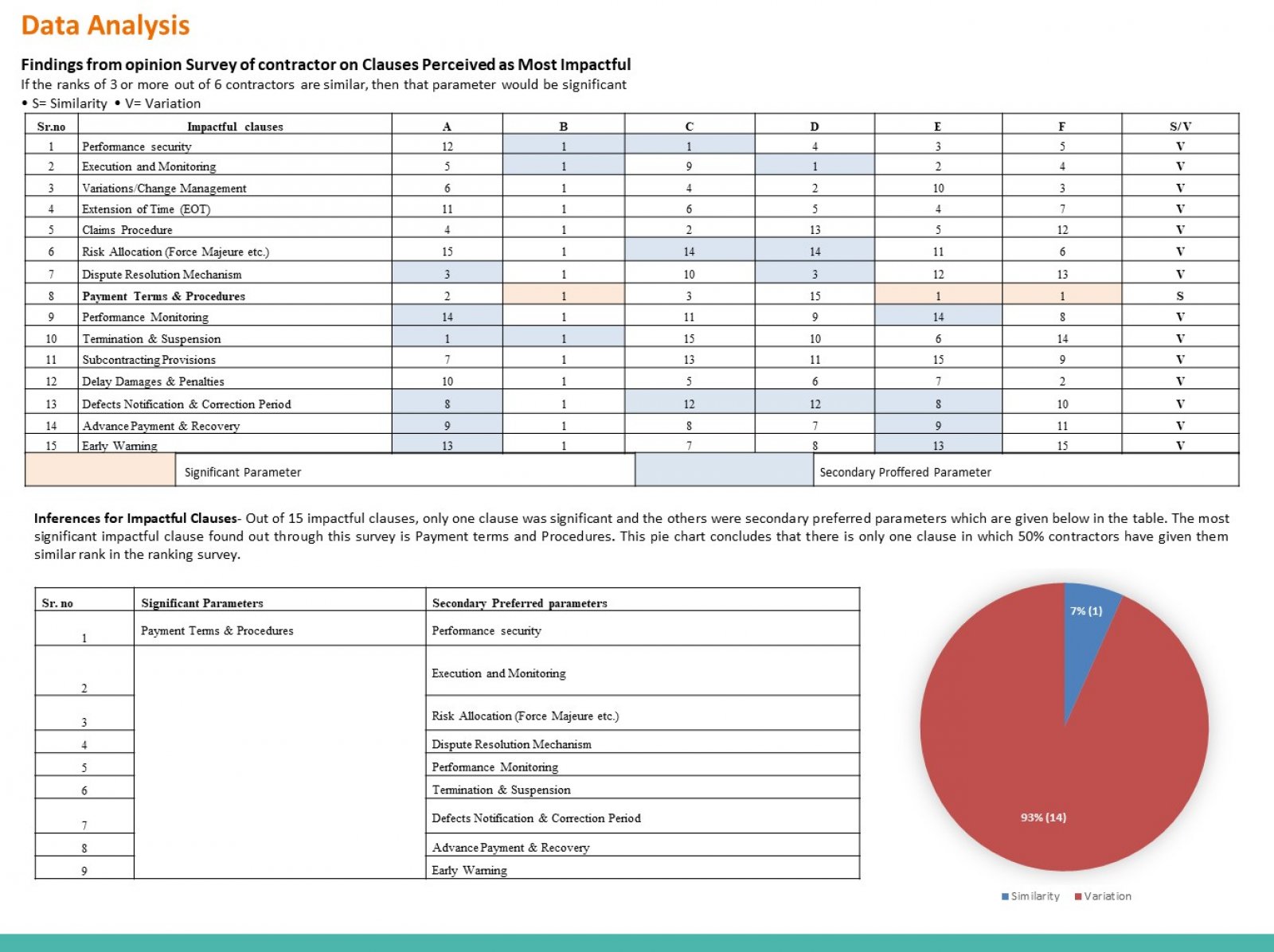

Findings from opinion Survey of contractor on Clauses Perceived as Most Impactful

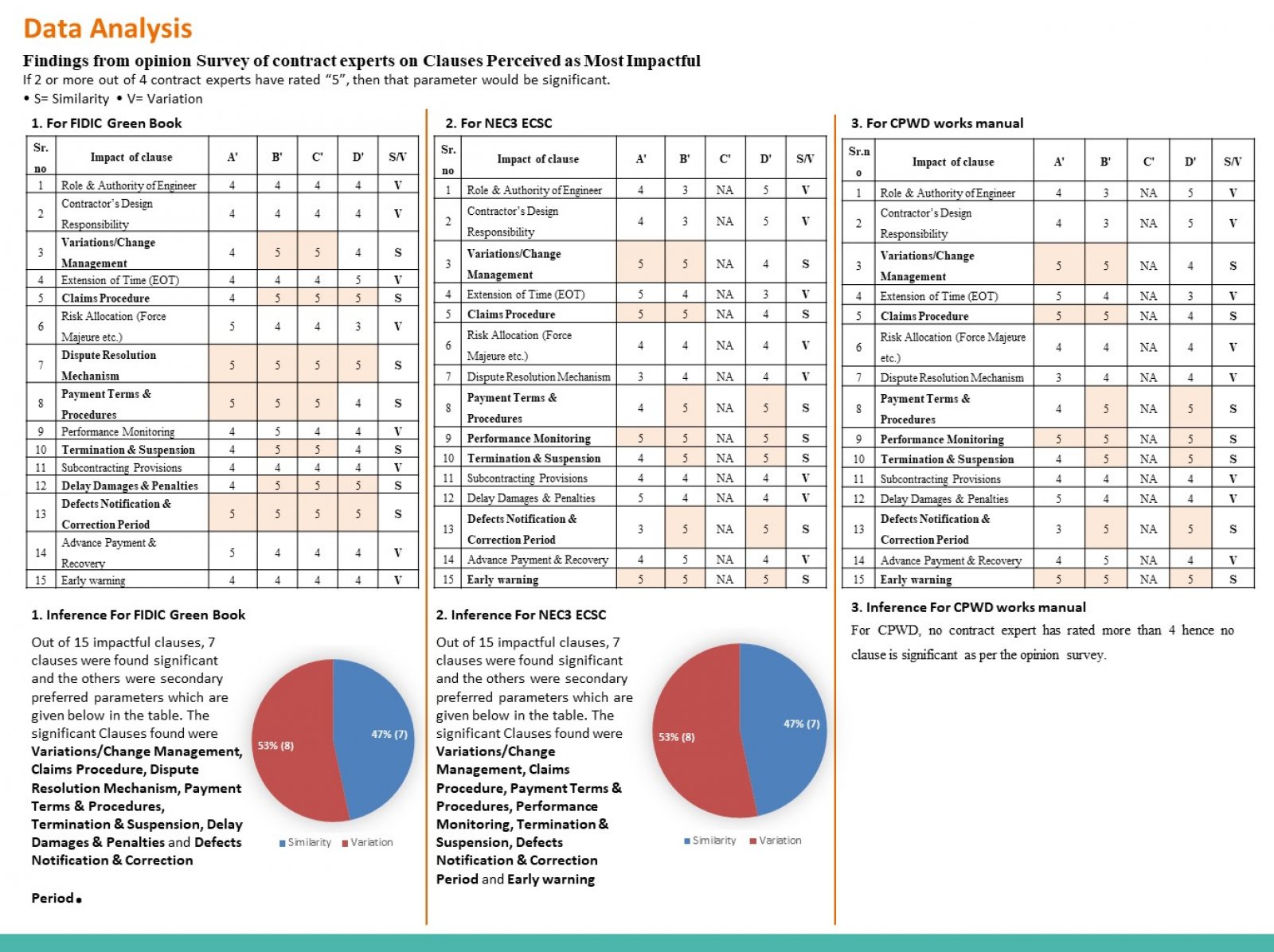

Findings from opinion Survey of contract experts on Clauses Perceived as Most Impactful

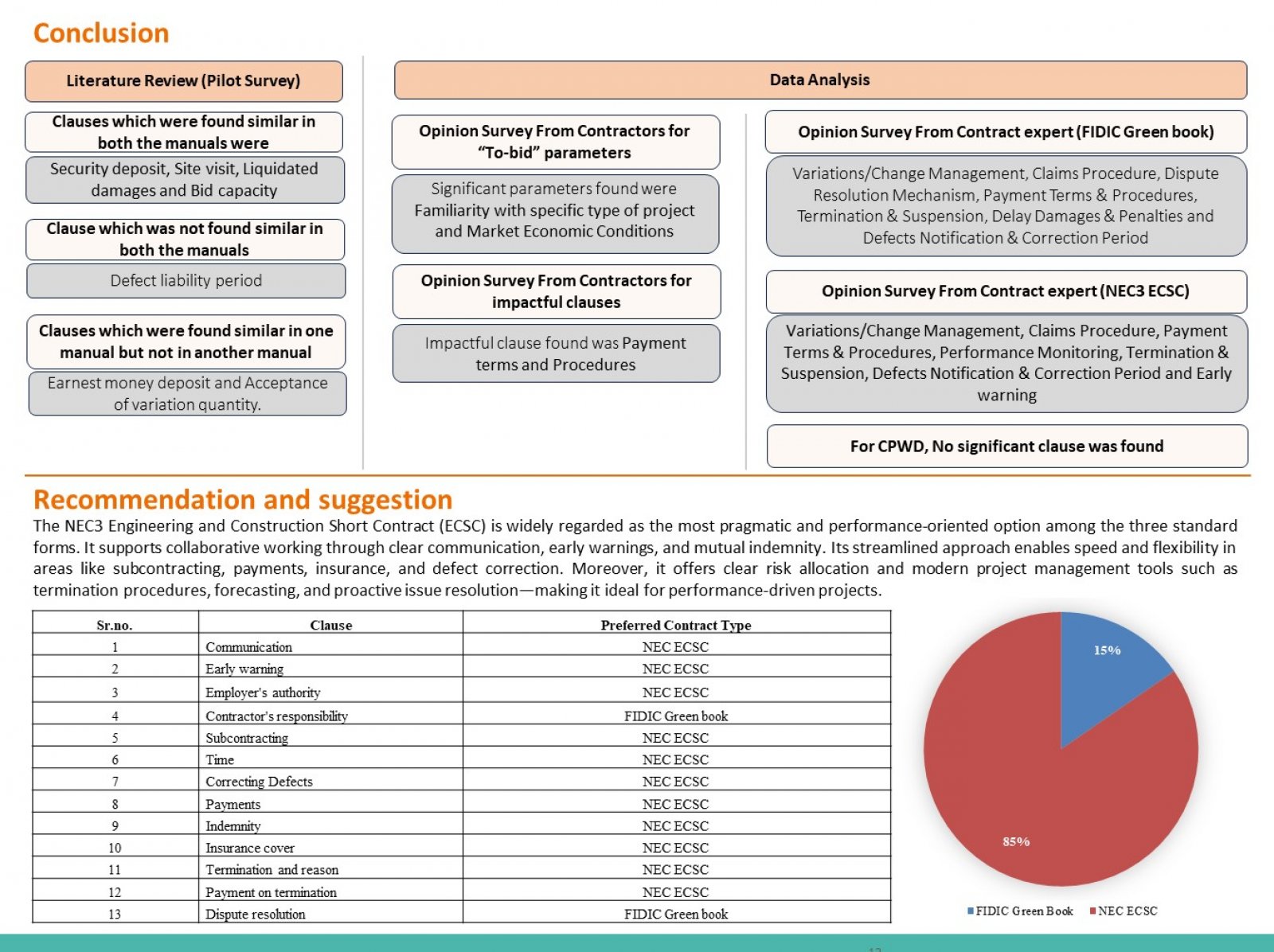

Conclusion and recommendation from the analysis
